Achievement Rates App Analysis

This report applies only to English contracts.

Certain programme aims are excluded from the Apprenticeship Achievement Rates. The exclusion rules are applied based on the QAR ruleset that you run the report with (this can be chosen in the parameters):

The Achievement Rates App Analysis report shows Ofsted Achievement Rate figures for Apprenticeships under a number of groupings. The groupings are highly customisable to allow for in-depth analysis.

Parameters

Layout

The report data has custom row (left) and column (top) groupings which are determined by the parameters. These can be expanded and collapsed by clicking the and buttons. The final row group has two fixed groupings for different types of Apprenticeship achievement.

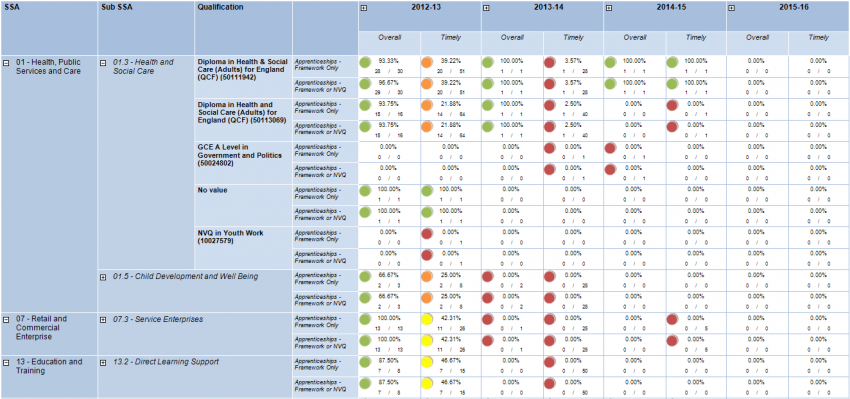

For each grouping, the data area shows the achievement percentage, the number of learners who have achieved and the total number of learners in the cohort. There is also a 'traffic light' (green, amber or red) which is set according to the values in the threshold parameters. This allows you to quickly see general achievement levels for each area.

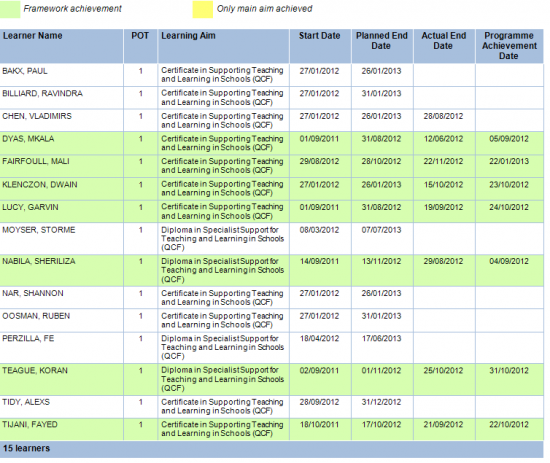

Clicking the right-hand number will show a list of all the learners in that particular cohort. Clicking the left-hand number will show the learners in the cohort who are achievers. Note that there are two rows showing slightly different measurements of achievement:

Explanation of Timely and Overall Cohorts

Achievement Rates are measured in overall and timely cohorts, which are defined by the ESFA. A cohort is simply a group of learners during a period of time. The Maytas Achievement Rate reports distinguish between cohort years (based on contract years) and cohort months. For example, a learner with a timely cohort month of August 2015 would have a timely cohort year of 2015/16.

Timely Cohort

A learner's timely cohort is determined by the month/year in which their planned end date falls. For example, if a learner had a planned end date of 01/09/2015, their timely cohort month would be September 2015 and their timely cohort year would be 2015/16.

To be a timely achiever, a learner must achieve their main aim or framework within 90 days of their planned end date (or before the planned end date). This requires a programme aim completion status of 2 (completed) and a programme aim outcome of 1 (achieved), and the actual end date must be no more than 90 days after the planned end date. The Maytas Achievement Rate reports distinguish between timely framework achievers and timely NVQ (i.e. main aim) achievers. If a learner is a timely achiever, their timely achiever cohort year and month is the same as their timely cohort.

It is important to note that the 90 day rule only applies when determining timely achievers, not the timely cohort. i.e. If a learner leaves more than 90 days after their planned end date, they would not be counted as a timely achiever but they would still be counted in the timely cohort.

The timely cohort can include live learners as well as leavers.

Overall Cohort

A learner's overall cohort is determined by the month/year in which the most recent of the planned end date and the actual end date falls. In other words, if the planned end date is after the actual end date, the planned end date is used, otherwise the actual end date is used.

It is important to note that the overall cohort only includes leavers (i.e. learners with an actual end date), unlike the timely cohort.

To be an overall achiever, a learner must achieve their main aim or framework. This requires a programme aim completion status of 2 (completed) and a programme aim outcome of 1 (achieved). Unlike the timely cohort, it does not matter when the achievement takes place. The Maytas Achievement Rate reports distinguish between overall framework achievers and overall NVQ (i.e. main aim) achievers. If a learner is an overall achiever, their overall achiever cohort year and month is the same as their overall cohort.

Forecasting

The Forecast data parameter has three options:

For the best case and worst case scenarios, if the planned end date is in the past then the completion is forecast for the current period. The exception to this is when learners in the timely cohort are still live and more than 90 days past the planned end date, in which case they are forecast to complete without achievement in the current period.

There are certain situations worth noting when using the forecasting:

Achievement Rates Reconciling vs Anticipated Results

We have received queries and feedback from providers around how the achievement rates data is produced and what that data represents. Since the major QAR rule changes were introduced in January 2017, our intention has been to produce what we expect the latest published QAR results to be. This means that in some cases, data which was exported in recent contract years has been ignored in favour of earlier data, as the earlier data is what we expect the ESFA to be using to produce the latest QARs.

While this is the most accurate way to reconcile against current published figures, it is not useful for showing future expected results based on current data. To address this, the reports allow you to toggle between these two options with the Reconcile or predict parameter:

Top-Level Employer Groupings

The report can be configured so that the Employer groupings will consolidate learners on employer branches under their top-level employer instead. With the config disabled, the groupings will work as they previously did (i.e. learners will be grouped by individual employers and branches).

To enable this feature:

  1. Click the M5 button at the top left and select Options.
  2. Go to Reports Library on the left (in the Maytas 5 section).
  3. On the right, in the Achievement Rates section, tick the box for the config Merge branches under top-level employers in QAR reports and ensure the toggle button is set to ON.
  4. Click OK.
