Financial Planning

The Financial Planning module requires a licence – please contact your account manager for more information.

The Financial Planning module is a suite of tools for producing ESFA financial forecasts and “what if” scenarios to help you plan your financial goals and expected provision requirements for future years. Plans are created against a contract and allow you to quickly and easily experiment with scenarios to see what effect they would have.

Plans can also be used as the basis for profiling so that performance can be measured against it. The plan can then be modelled to see what would happen if things don't go as expected (e.g. a sudden increase or decrease in learner intake).

Each financial plan uses a combination of hypothetical (or 'what-if') figures and actual financial figures. Currently, only figures for funding model 35 (adult skills funding) and 36 (apprenticeships) are calculated for what-if figures, whereas the actual figures include all ESFA funding in Maytas. There are options to view only actual figures, only what-if figures or both merged together.

Before the Financial Planning module can be used, an admin user must enable it:

  1. Go to Tools | Edit Permissions.
  2. Select the user or group that requires permission.
  3. On the Modules tab, set the dropdown box for Financial Planning Module to Visible.
  4. Click Apply.

Once enabled, the module can be accessed by clicking Financial Plans on the Management toolbar.

Overview

Create a New Plan

To create a new financial plan:

  1. Go to Management | Financial Plans.

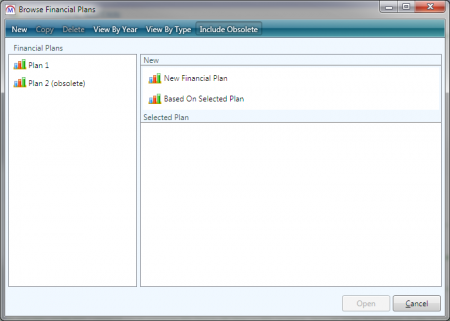

  2. Double-click New Financial Plan.

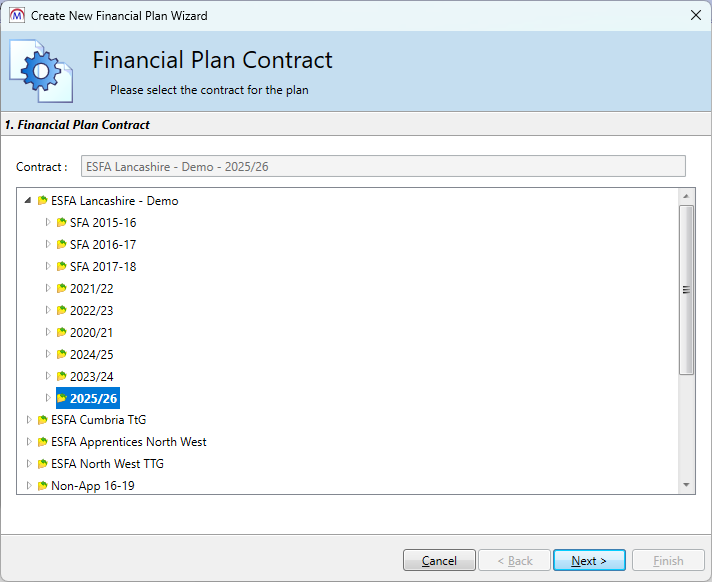

  3. Expand a contractor and select the contract on which the financial plan will be based. For funding model 35, this must be a contract for 2015/16 or later, and for funding model 36 it must be a contract for 2017/18 or later.
  4. Click Next.
  5. Enter a name for the plan. You can also optionally select a type of plan (ESFA or other) and give the plan a version number, reference and variation date.
  6. Click Next.

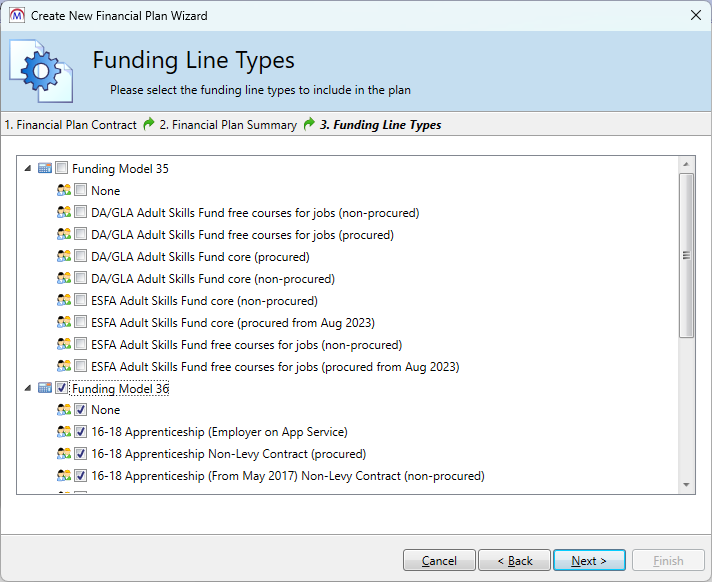

  7. On this screen you can choose the funding models and funding line types to include in the plan, which can be a combination of FM35 and FM36. Click Next.

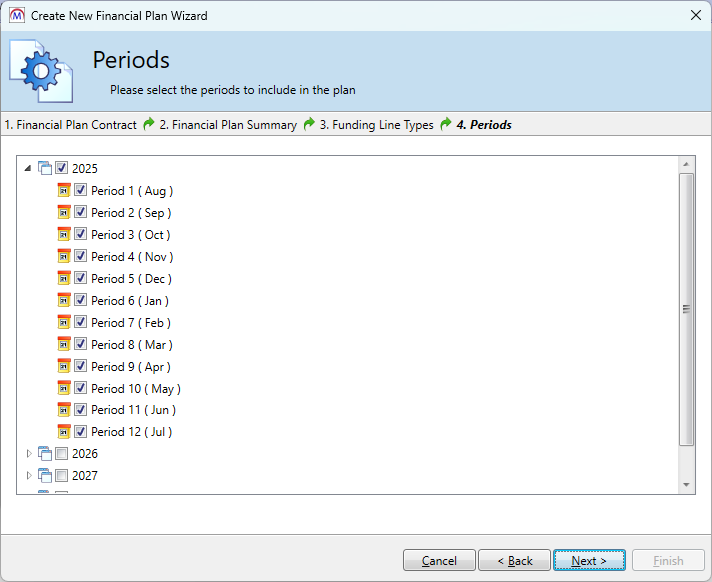

  8. Select the years and periods to be included in the plan (this determines how far forward the plan will forecast, with a maximum of four years into the future). Please note that the selected periods must be sequential. Click Next when finished.
  9. Click Finish.

Tabs Summary

There are eight standard financial plan tabs:

Tab Details

Plan Summary

The Plan Summary tab shows basic details about the plan.

Notes

The Notes tab allows you to enter general notes about the plan (e.g. the scenarios it is intended to model).

Default Assumptions

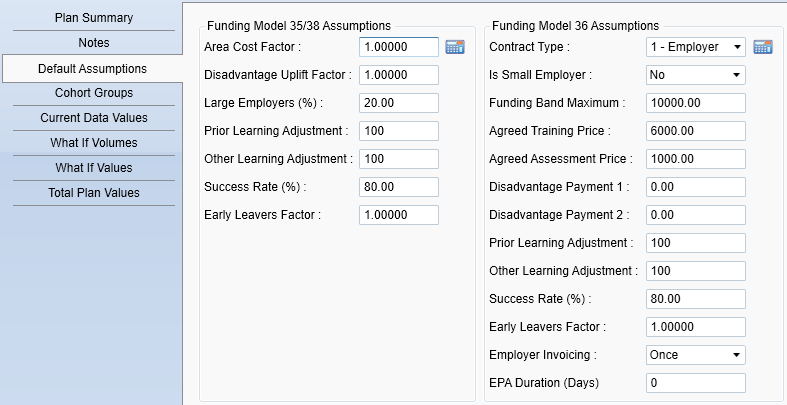

The Default Assumptions tab defines the list of assumed modifiers which will be applied to the plan's forecasted figures. These can be overridden by defining assumptions for specific cohort groups or aims.

For example, the default success rate percentage of 80 means the plan assumes 80% of forecasted starters will achieve. If, however, we went to the Cohort Groups tab and specified that 16-18 Apprenticeships will have a success rate of 60%, the 60% rate would be applied to that particular group (the default of 80% would still be applied to every other group in the plan).

The button allows you to replace the standard default assumptions with ones calculated from your data instead. The following window will appear:

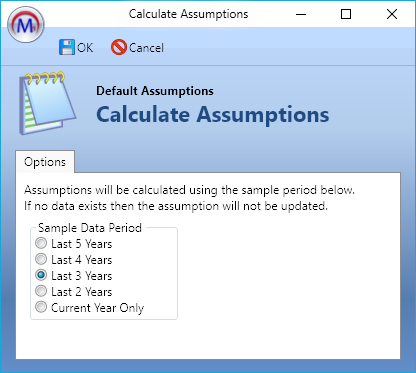

The assumptions will be calculated from a sample of data over the period you select (last 5, 4, 3 or 2 years or the current year only). If no data is available to calculate an assumption, the standard assumption will remain instead. Select an option and click OK.

For information on funding terms and what they mean in terms of funding calculations, please refer to the ESFA's published funding documentation.

Cohort Groups

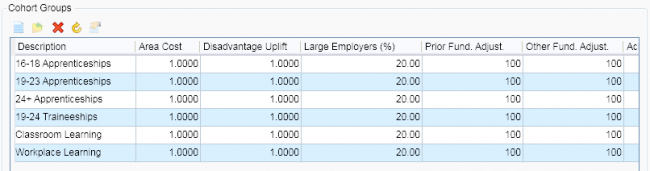

The Cohort Groups tab defines the rates, durations and assumed modifiers for different types of forecasted provision.

The initial set of cohort groups is determined by the types of provision selected in the wizard when the plan is created. These can be amended or deleted as required, and new cohort groups can be added.

The Field View dropdown box at the top right lets you choose whether to show FM36 assumptions, FM35 assumptions or both.

The assumptions for each group are initially taken from the default assumptions for the plan. These can be edited manually (see below), or they can be calculated per group based on averages from your data. To do this, click the button. The following window will appear:

The assumptions will be calculated from a sample of data over the period you select (last 5, 4, 3 or 2 years or the current year only). If no data is available to calculate an assumption, the default assumption will remain instead. If the Calculate assumptions for all cohort group aims box is ticked, the assumptions will be calculated for all of the aims within each group. Select an option and click OK.

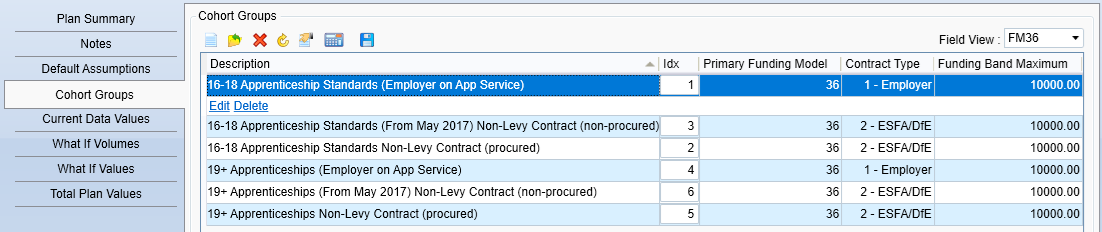

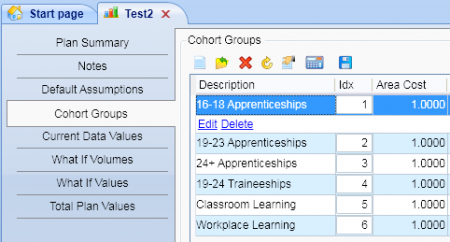

To edit a cohort group, select it and click Edit.

To add a cohort group, click the button.

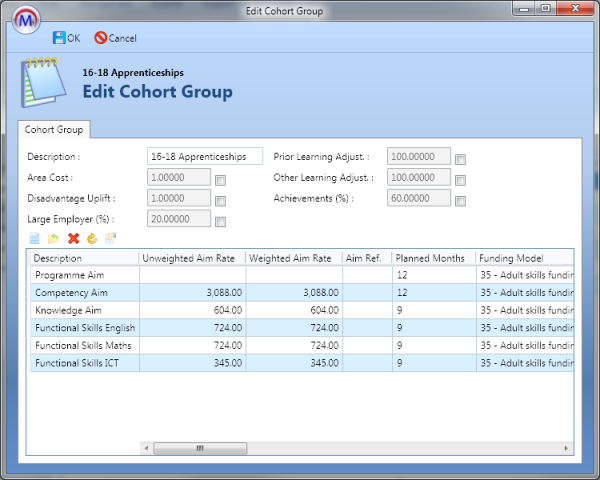

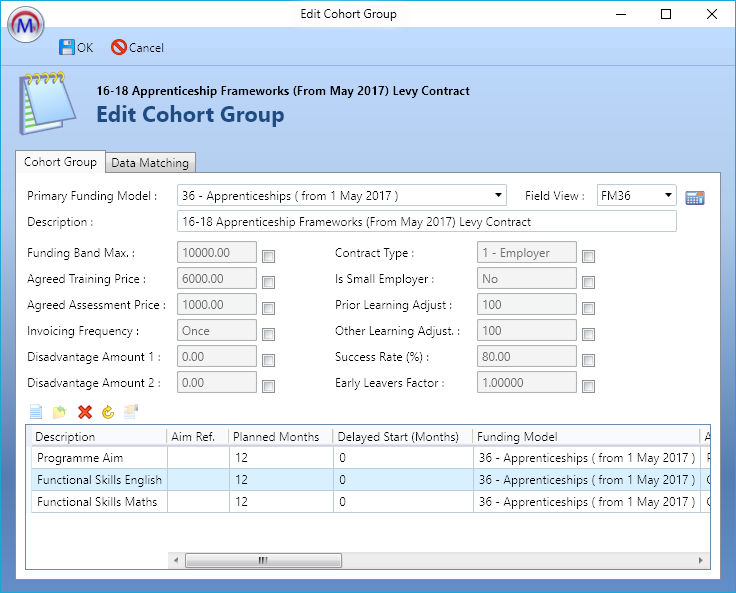

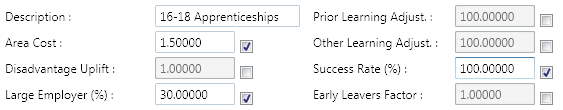

On the Edit Cohort Group screen you can amend the description, set specific assumptions for the group and add / modify the aim rates and other details. You can also toggle between FM35 and FM36 settings using the Field View dropdown box at the top-right.

The assumptions are greyed-out initially and display the default assumptions for the plan. To apply a custom assumption to the group rather than the default, tick the box next to it and edit as required.

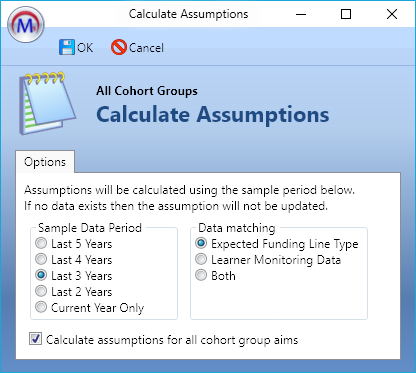

The button can be used to calculate the assumptions based on your data (see above).

The Expected Funding Line box determines which aims will be included when calculating the averages for the assumptions (i.e. only aims with the selected funding line type will be included).

The aims shown at the bottom of the screen are pre-defined in the cohort groups generated by the plan wizard. However, they can be amended or deleted as required, and new aims can be defined for the group. The aims can be defined for specific aim references or can be generic aim templates (e.g. for an Apprenticeship you would have a programme aim and several component aims of various types, but these do not have to map to specific references).

To edit an aim, select it and click Edit.

To add an aim, click the button.

The Edit Cohort Group Aim Details window has four tabs: Aim Details, Funding Factors, Aim Rates and Type and Specific Aim Details. The intention is that the Aim Details tab should be completed in all cases (Funding Model and Aim Type at minimum) and then you should complete either:

This is because Specific Aim Details retrieves aim information from the FIS for a particular aim, and the retrieved information is what would otherwise be entered on the other two tabs. Please note that the fields available on these tabs are different depending on which funding model is selected on the Aim Details tab.

Aim Details

Funding Factors

Aim Rates and Type

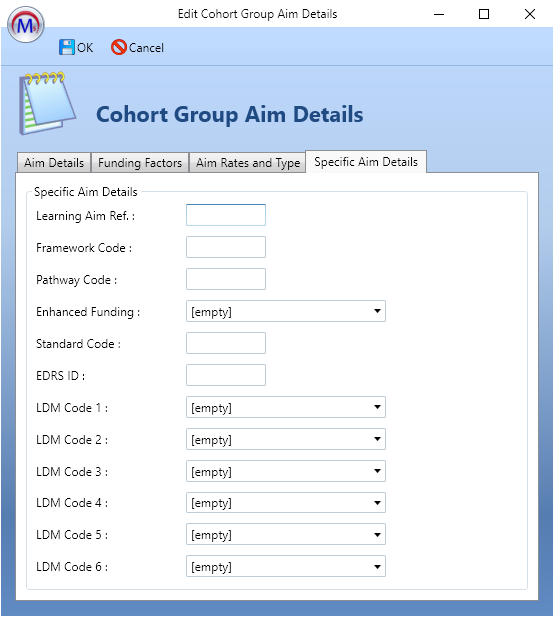

Specific Aim Details

Copy cohort groups

New cohort groups can be created by copying an existing group and then editing it as required:

  1. Go to Management | Financial Plans and open the plan you wish to edit.
  2. Go to the Cohort Groups tab.

  3. Select the plan you wish to copy and click the button.

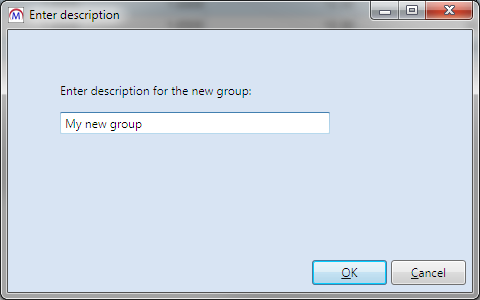

  4. Enter a name for the new group and click OK.

  5. The new group will appear and the list and can be amended as normal. All details from the copied group will be present in the new one.

Manually sort cohort groups

Cohort groups can be manually sorted by entering an index number against them:

  1. Go to Management | Financial Plans and open the plan you wish to edit.
  2. Go to the Cohort Groups tab.

  3. The Idx column determines the order in which the groups appear (by default this will be alphabetical). Edit the Idx numbers as required to create the new order.
  4. Click Apply.
  5. Close and re-open the plan for the new ordering to be appear.

Current Data Values

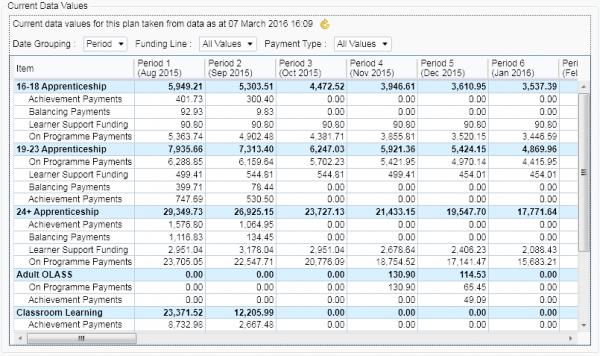

The Current Data Values tab shows the actual ESFA funding figures from Maytas. The first time you view this screen after creating a plan, all the figures will be zero as the data needs refreshing. Click the button to do this. Once finished, a date and time will appear next to the refresh button, which indicates the date and time that the funding cache was updated, not the time that this screen was refreshed.

There are three filters for displaying data:

What If Volumes

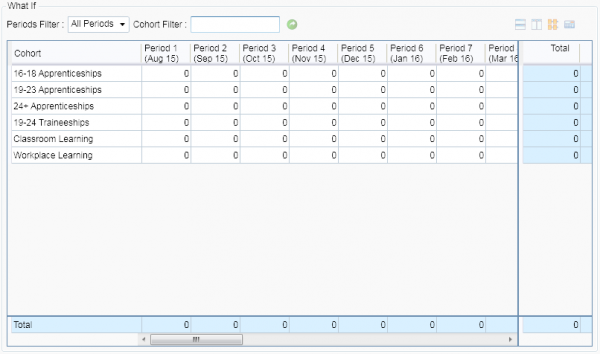

The What If Volumes tab is where you enter the number of learners to forecast. The period in which you enter a volume is the period in which those learners will be forecasted to start, and subsequent periods will forecast OPP payments, achievements, etc, as defined in each cohort group. For example, if you entered a volume of 5 for every period, that would not indicate that there are 5 learners in learning each period but rather that are 5 starters each period.

To enter a volume, click in the grid, enter the number, click another box and click Apply.

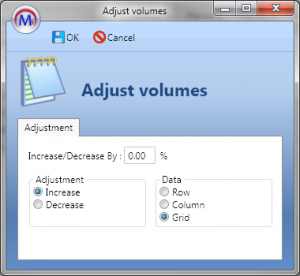

There are four buttons which help with entering volumes in bulk by propagating the volumes across the grid. To use them, click a volume in the grid and then click one of the buttons:

You may wish to only change or propagate volumes for a particular timeframe - e.g. you may wish to change the volumes for only a single year rather than all years in the plan. To do this, use the Periods Filter to choose the timeframe you require.

You can also filter by cohort groups (shown on the left of the grid). To do this, enter the full or partial name of the cohort in the Cohort Filter box and click the button.

What If Values

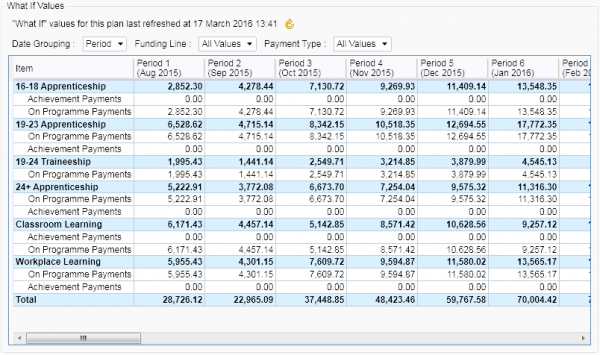

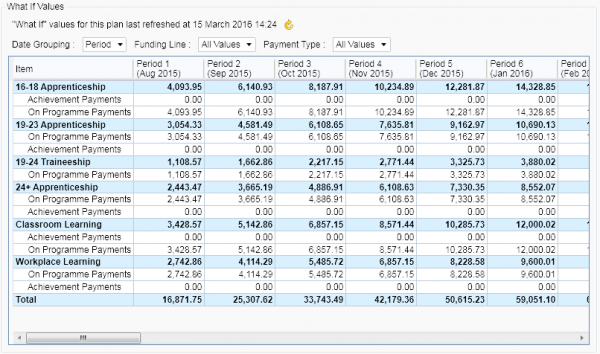

The What If Values tab shows the forecasted financial figures based on the aim details defined in the cohort groups and the volumes entered on the What If Volumes tab. As with the Current Data Values tab, the figures will all be zero the first time you go to this tab after creating a plan as the data must be refreshed. Click the button to do this. The date that appears next to the button shows the date that this screen was last refreshed. In general it is a good idea to refresh this screen after making changes on the Cohort Groups tab or the What If Volumes tab.

There are three filters for displaying data:

Total Plan Values

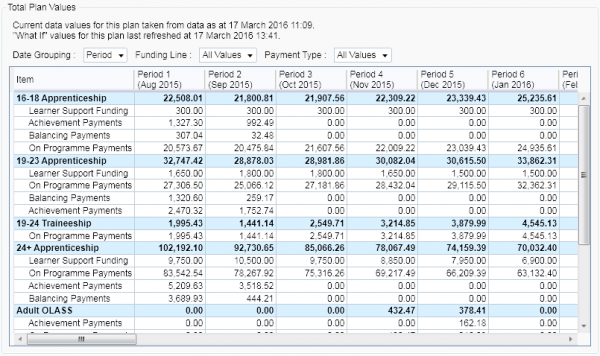

The Total Plan Values tab shows a combination of data from the Current Data Values and What If Values tabs - i.e. the total value of actual and forecasted financial figures. The data on this screen does not need to be manually refreshed as it simply combines the data from the other two values tabs (which do need to be refreshed).

There are three filters for displaying data:

Funding Model 36 Notes

Forecast Completion Rate

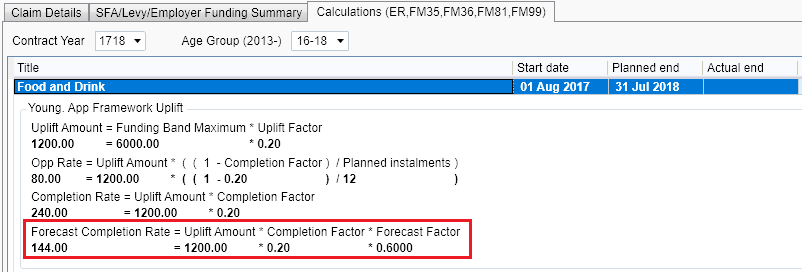

The forecast completion rate calculation can be found on the Claim Details calculations tab for FM36:

  1. Open the record for a learner on funding model 36 and go to the Claim Details tab.
  2. On the Calculations tab, the forecast completion rate can be found in the framework uplift section.

Note that this uses the default forecast factor, which is overridden in financial plans by the success rate assumption value.

Employer Balancing Payments

Employer balancing payments are included in the what-ifs and current values for financial planning for FM36 plans where the funding band maximum is less than the total price (for the what-if values, this is determined in the assumptions where Funding Band Maximum is less than Agreed Training Price + Agreed Assessment Price).

The following assumptions are made for employer balancing payments:

  1. Invoicing is assumed to be in advance.
  2. The payments are not invoiced after the actual end date.
  3. Where there is a residual change in price, the invoicing frequency starts again from the price date.
  4. Where there is a change in price after the planned payments, a one-off balancing payment may be generated, providing that the actual end date has not been reached.

Example Plans

Basic Forecast

For this example, we will create a basic three year plan using the default assumptions.

  1. Go to Management | Financial Plans and double-click New Financial Plan.
  2. For this example we will select a 2015/16 contract for an ESFA contractor, selecting all funding provision types and all periods for 2015, 2016 and 2017.
  3. Once the wizard has been completed, go to the Current Data Values tab.

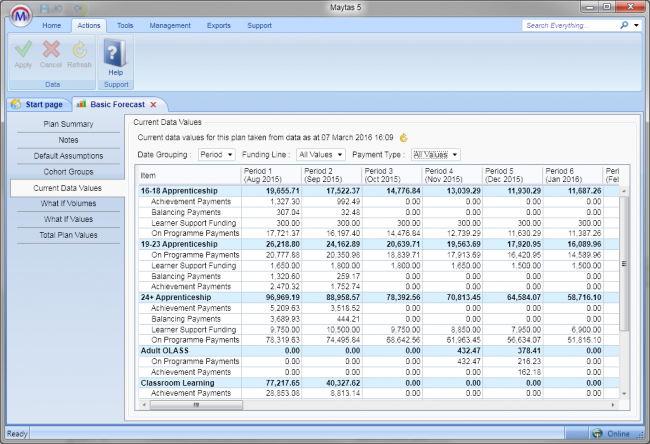

  4. All values will be at zero. This is because the values need refreshing when a plan is first created. Click the button to refresh the current values (click Yes to confirm).

    The values are populated from the cached funding information generated by Maytas. The date and time displayed next to the button indicates when the funding cache was refreshed, not when the values on this screen were refreshed. The funding cache will be set to periodically refresh out-of-hours on most systems, but it can be manually run by going to Management | Profiles and click the Funding Cache button (on large databases this may take a long time and can slow down the system while running).

  5. Next, go to the What If Volumes tab.

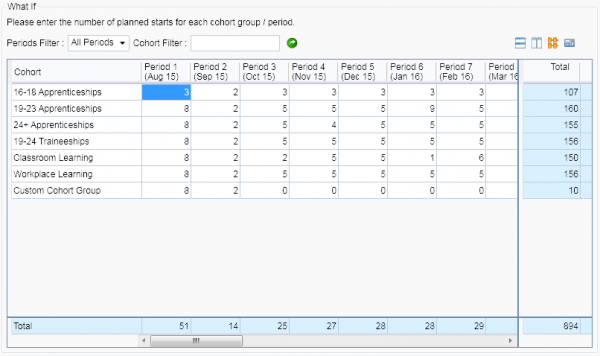

  6. Enter a number in the top-left box (for this example we will forecast for 5 starters).
  7. Select the top-left cell and click the button to cascade this value across all periods in the plan – i.e. so that there are 5 starters per period and cohort. Click Apply when finished.
  8. Go to the What If Values tab.
  9. Click the button to refresh the forecasted values (click Yes to confirm).

    Please note that the date and time next to the button refers to when the forecasted values were updated, unlike the Current Data Values tab where it refers to when the funding cache was updated.

  10. The combination of current data and forecasted data can now be viewed on the Total Plan Values tab.

Now that a basic plan has been created, we can modify the “what if” values to see what effect this has on the forecast. For this example, we will model the financial impact of learner intake dropping from 5 learners each period/cohort to 3 learners each period/cohort in year 3:

  1. Go to the What If Volumes tab.
  2. From the Periods Filter dropdown box, choose Year 3 (2017). This will filter the grid so that it only shows the periods in year 3.
  3. Enter 3 in the top-left box, then click out of the box and click Apply.
  4. Select the top-left box and click the button to cascade the new value across all periods and cohorts in year 3.
  5. Click Apply.
  6. Go to the What If Values tab. Note that the current total value should be approximately £3m based on the default assumptions and volumes of 5 learners per period/cohort.
  7. Click the button to refresh the results. The total value will drop to approximately £2.7m (the values for each period and cohort will also be updated accordingly).

Modifying Assumptions

Using the plan created in the previous example, we will now model the effect of changing the default assumptions:

  1. Open the plan if it is not already open and go to the Default Assumptions tab.

  2. These are the assumptions that are used across the entire plan unless different assumptions are specified for particular cohort groups. For this example we will change the achievements % to 60. Click out of the box once the figure is changed and click Apply.
  3. Go to the What If Values tab and click the button to refresh the results. The total value will drop from £2.7m to £2.6m.

Modifying the default assumptions offers many forecasting possibilities, such as modelling best and worst case scenarios (i.e. 100% and 0% achievements).

Cohort Groups

Using the plan from the previous examples, we will now modify the cohort groups to model scenarios for specific types of provision, first by overriding the default assumption for the achievement percentage and by seeing the effect of a substantial increase in competency aim rates for 16-18 Apprenticeships:

  1. Open the plan if it is not already open and go to the Cohort Groups tab.

  2. Select 16-18 Apprenticeships and click Edit.

  3. Here we can see greyed-out assumptions which match the figures from the Default Assumptions tab. These figures can be overridden for the cohort group. Tick the Achievements (%) box and change the value to 100.
  4. The aim details and rates at the bottom of the screen can also be modified. Select the Competency Aim row and click Edit.
  5. Go to the Aim Rates and Type tab.

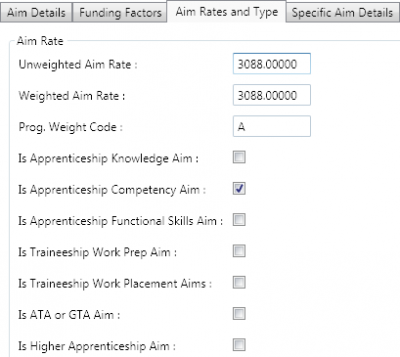

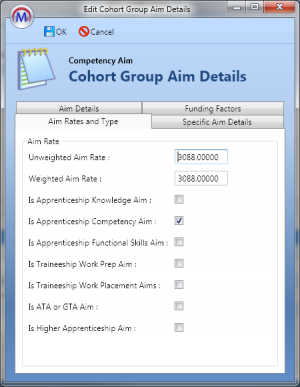

  6. Change the Unweighted Aim Rate and Weighted Aim Rate to 4088.
  7. Click OK, then click OK again and click Apply.

Next we will add a custom aim rate to Workplace Learning:

  1. On the Cohort Groups tab, select Workplace Learning and click Edit.

  2. Currently, Workplace Learning only has a rate for the main aim. For this example we will model the effect of adding a custom aim to this cohort group. Click the button.

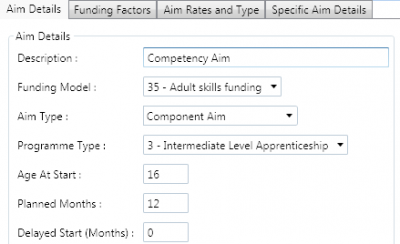

  3. On the Aim Details tab, enter the description as Custom Aim, set the funding model to 35, set the aim type to Other Aim, set the age at start to 19 and set the planned months to 6.
  4. On the Aim Rates and Type tab, set the unweighted and weighted aim rates to 100.

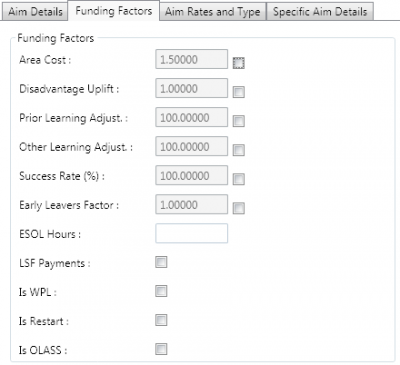

  5. On the Funding Factors tab, tick the Is WPL checkbox.
  6. Click OK, then click OK again and click Apply.

Finally we will add a new cohort group:

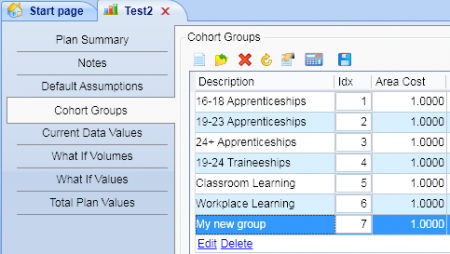

  1. On the Cohort Groups tab, click the button.
  2. Enter Custom Cohort Group as the description.
  3. Click the button to add a new aim rate.
  4. On the Aim Details tab, enter Custom Aim as the description, set the funding model to 35, set the aim type to Other Aim and enter 12 in the planned months box.

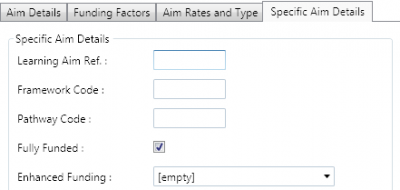

  5. Go to the Specific Aim Details tab.

    The Specific Aim Details tab allows you to retrieve aim information for a particular aim from the FIS tables.

  6. Enter 5008818X in the learning aim ref box and tick the Fully Funded checkbox.
  7. Click OK, click OK again then click Apply.
  8. Go to the What If Values tab and click the button to refresh the results.
